March 27, 2026
Realistic Timelines for a Houston Bathroom Remodel in 2026: From Permits to Final Polish
Realistic Timelines for a Houston Bathroom Remodel in 2026: From Permits to Final Polish

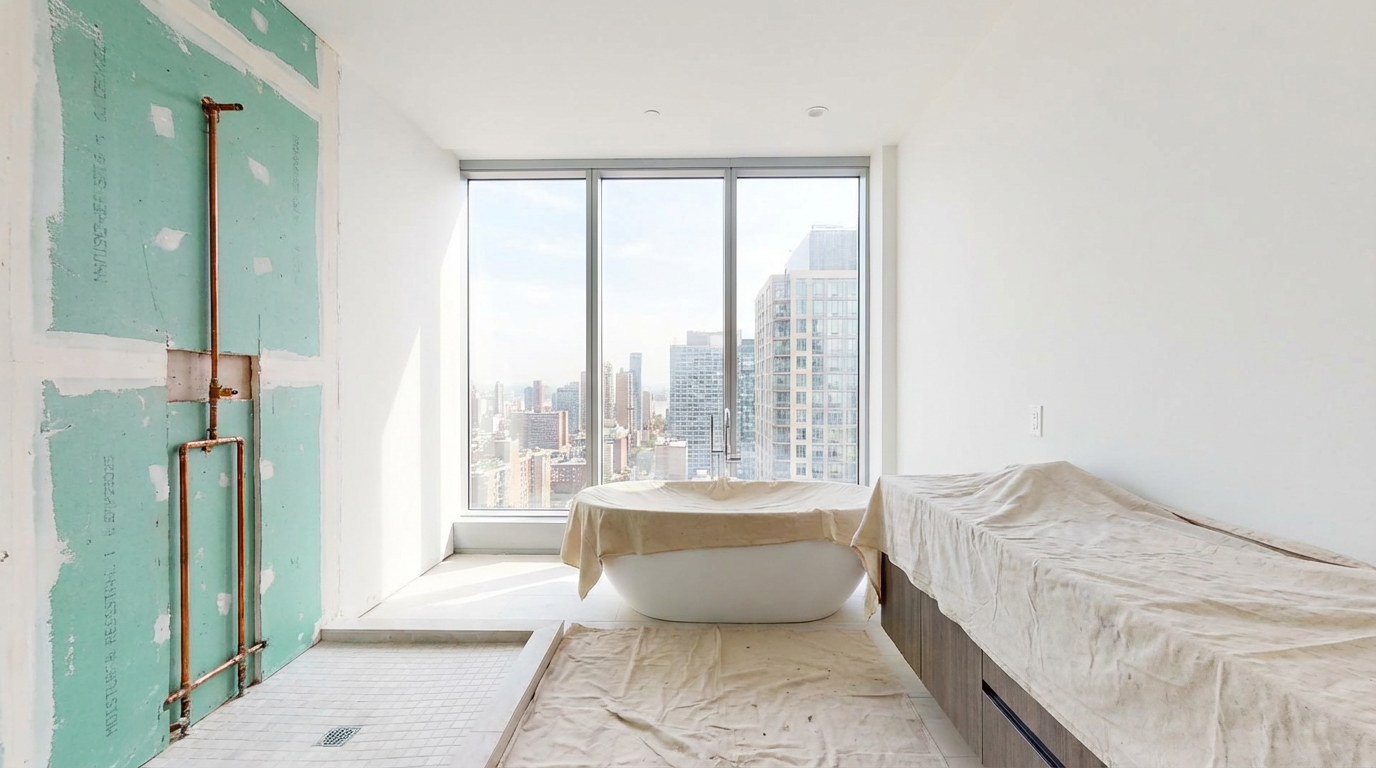

In 2026, a comprehensive bathroom remodel in Houston typically takes between 6 to 12 weeks from the start of construction to the final walkthrough. This timeline accounts for the current 2-to-4-week remodeling permit timeline in Houston and the phased approach required for plumbing, electrical, and custom finishes. Factors such as structural changes, material lead times, and city inspection schedules play the most significant roles in determining the final duration of your project.
In 2026, a comprehensive bathroom remodel in Houston typically takes between 6 to 12 weeks from the start of construction to the final walkthrough. This timeline accounts for the current 2-to-4-week remodeling permit timeline in Houston and the phased approach required for plumbing, electrical, and custom finishes. Factors such as structural changes, material lead times, and city inspection schedules play the most significant roles in determining the final duration of your project.
How Long Does a Houston Bathroom Remodel Take?
A standard bathroom renovation follows a structured timeline divided into three main phases: pre-construction, active construction, and final finishing. For most Houston homeowners, the active construction phase remains the most disruptive, typically lasting 4 to 8 weeks depending on the complexity of the design and the efficiency of your houston bathroom remodeler.
In practice, timelines are often extended not by the speed of the contractors, but by "critical path" items—tasks that must be completed before the next step can begin. For example, a custom glass shower enclosure cannot be measured until the tile is fully installed, often adding a 10-to-14-day lead time toward the end of the project.
Understanding the Remodeling Permit Timeline in Houston
The City of Houston Houston Permitting Center currently processes residential remodeling permits within 10 to 20 business days for standard interior renovations. If your project involves expanding the footprint of the bathroom or making significant structural changes, expect the review process to take longer.
A professional remodeler in Houston will typically handle the permit application for you, ensuring that plans meet the 2021 International Residential Code (IRC) standards currently adopted by the city. Working without a permit in Houston can result in "stop-work" orders and significant fines, effectively doubling your project timeline and cost.
📊 Typical Time Allocation for Bathroom Renovation Phases
Design & Planning: 20%
Design & Planning20%
Permitting & Procurement: 25%
Permitting & Procurement25%
Demolition & Rough-In: 15%
Demolition & Rough-In15%
Tile & Finishes: 30%
Tile & Finishes30%
Final Polish & Inspection: 10%
Final Polish & Inspection10%

What are the Main Bathroom Renovation Phases?
The bathroom renovation process is a sequential series of events where each trade must finish their work before the next begins. Based on real-world results from local projects, the most efficient builds follow a strict "dry-in" to "finish-out" pipeline.
Phase 1: Planning and Procurement (4–6 Weeks)
Before a single tile is removed, a bathroom remodeler in Houston must finalize the design and order all long-lead items. In 2026, supply chain stability has improved, but custom vanities and high-end Italian tiles still require 4 to 8 weeks for delivery.
Design Selection: Choosing fixtures, lighting, and layout.
Material Ordering: Securing "on-site" dates for all materials.
Permit Filing: Submitting plans to the City of Houston.
Phase 2: Demolition and Rough-In (1–2 Weeks)
This is the "messy" phase. Demolition usually takes 2 to 3 days, followed immediately by the "rough-in" of new plumbing and electrical lines.
Plumbing Rough-In: Moving drains or installing new valves (e.g., for a rainfall showerhead).
Electrical: Updating wiring to meet GFCI codes and installing recessed lighting.
Inspections: The City of Houston must inspect "open-wall" plumbing and electrical work before they are covered by drywall.
Phase 3: Waterproofing and Tile Work (2–3 Weeks)
This is the most time-consuming portion of the build. Proper waterproofing is essential in Houston’s humid climate to prevent mold. We utilize systems like Schluter-Kerdi to ensure a 100% waterproof seal.
Cement Board/Waterproofing: Ensures the shower stall is airtight.
Tile Installation: Large format tiles or complex herringbone patterns take significantly longer than standard subway tiles.
- Grouting: Requires a 24-hour cure period before proceeding.
ℹ️ Info
Pro Tip: Always choose your tile and grout at least 6 weeks before your start date. In the Houston market, premium porcelain and natural stone often sell out quickly, and waiting for a restock can stall your project for weeks.
What Factors Delay a Houston Remodeling Project?
Weather, labor availability, and inspection backlogs are the primary "variables" in any Houston construction schedule. While interior work is less affected by Houston's frequent rain, high humidity can impact the drying times for drywall mud, paint, and thin-set mortar.
City Inspection Scheduling
A common scenario we encounter is the "inspection gap." After a houston remodeler completes the rough-in, they must call for a city inspector. While these are usually scheduled within 48 hours, a failed inspection (even for a minor clerical error) can set the project back by a full week as the correction is made and a re-inspection is booked.
Change Orders and Scope Creep
Based on industry data, projects with two or more "change orders" (requests to change the design after work has started) experience a 25% increase in total project duration. To stay on schedule, finalize every detail—from the cabinet hardware to the grout color—before demolition begins.
📈 Impact of Change Orders on Project Completion Time (Total Hours)
No Changes: 320hrs320hrs
1 Change Order: 380hrs380hrs
2 Change Orders: 460hrs460hrs
3+ Changes (Est.): 580hrs580hrs
No Changes
1 Change Order
2 Change Orde…
3+ Changes (E…

Conclusion: Setting Realistic Expectations for 2026
Successful bathroom remodeling in Houston requires a balance of expert craftsmanship and meticulous scheduling. While a "quick flip" might take 3 weeks, a high-quality, permitted renovation by a professional houston bathroom remodeler will realistically take 8 to 10 weeks of active work. By understanding the remodeling permit timeline in Houston and the necessary bathroom renovation phases, you can plan your life around the construction and ensure a stress-free transformation.
"A remodel is only as fast as its slowest material. In the Houston market, the difference between a 6-week project and a 12-week project is almost always decided in the planning phase, not on the construction site." — Blue Jay Expert Insights
Ready to start your transformation?
Contact Blue Jay today to schedule a consultation with an expert remodeler in Houston. We specialize in transparent timelines and high-end finishes that stand the test of time.
Ready to start your transformation?
Contact Blue Jay today to schedule a consultation with an expert remodeler in Houston. We specialize in transparent timelines and high-end finishes that stand the test of time.
